These are the steps to performing a migration of Training into Veeva Quality Basics.
Sandbox Migration

Steps
Step 1 (Customer)
Populate the Veeva Quality Basics - Training Template.
Always download the latest version of the template. Do not reuse templates from previous migrations.
Step 2 (Customer)
Upload the completed Veeva Quality Basics - Training Template to the File Staging Server. Then use the Migration Communication Form to let Veeva know it has been uploaded.
Step 3 (Veeva)
Veeva will review your completed Veeva Quality Basics - Training Template and load Training data in your Sandbox.
Step 4 (Customer)
Review loaded Training data in Sandbox. Verify all records from the template have been migrated, confirm metadata is populated in the correct fields. If issues are found, first verify the correct value was in the template. If the issue persists, use the Migration Communication Form to let the Veeva Migration Team know.
Step 5 (Customer)
Develop any required migration documentation, such as a Migration Plan.
Step 6 (Customer)
Use the Migration Communication Form to schedule Production migration with Veeva.
Production Migration

Timeline
Production Migration must be requested and completed within seven (7) business days after Sandbox Migration is completed.
Steps

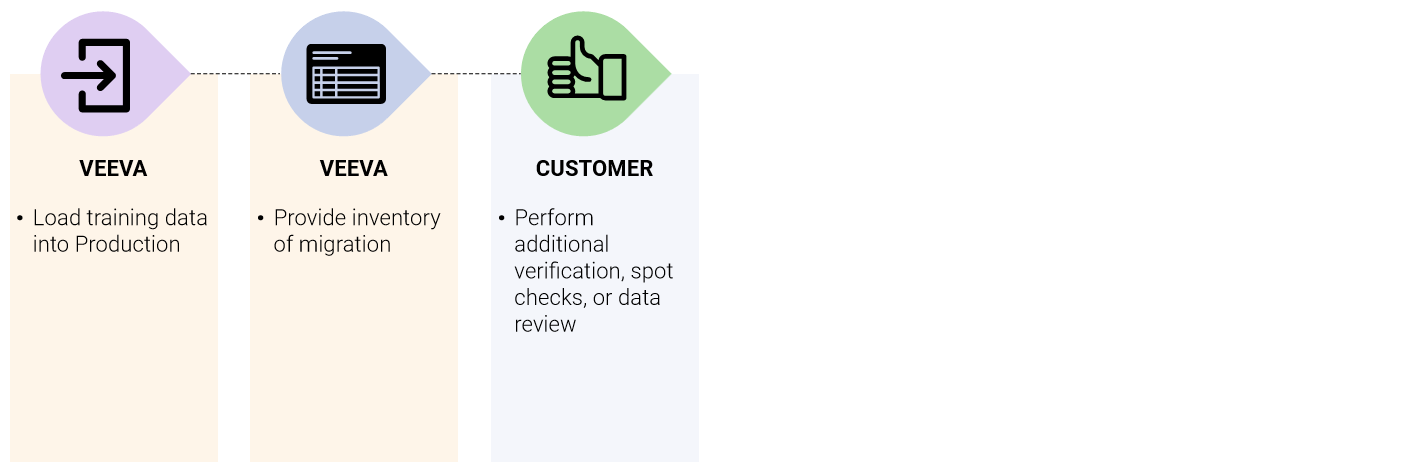

Step 1 (Veeva)
Veeva will load the Training data using templates the Customer confirmed are final when scheduling Production migration.
Step 2 (Veeva)
Veeva will provide:
- A populated Inventory of Migration.xlsx, listing the number of records migrated for each entity
- Loader sheets used for Production migration
- Log files
